A decade of step-free delay

In 2015, Sir Peter Hendy, now Lord Hendy and currently Minister of State for Rail, was appointed as Chair of Network Rail and tasked to conduct a review of the enhancement programme for Control Period 5, which ran from 2014-2019. From the resulting ‘Hendy Report’ this programme was “prioritised to reflect the government’s commitments to maximise passenger and freight user benefits” in light of issues with increased costs and deliverability. As a result, funding for ‘Access for All’ projects to deliver step-free railway stations was cut from £135m to £87.1m and 27 stations had their funding deferred until Control Period 6, 2019 – 2024.

This blog examines what progress has been made at these stations. In summary, of the 27 stations awarded funding in 2014, only 9 have been completed, with a further 8 due to be completed within the next six months or so (so by early 2025) and 10 stations either have no estimate of the completion date, a completion date of mid-2025 or beyond and in some cases it has been impossible to get any reliable information.

The time taken to research this information was lengthened considerably by the significant errors and discrepancies in the station information provided to the public by the rail industry, which are the ‘National Rail Map’, launched with great fanfare in April 2019 by the Rail Delivery Group, and the ‘National Rail Enquiries’ website. I contacted the relevant Train Operating Companies to ask them to correct their information. Some acknowledged their mistake and corrected it, some (I’ll name and shame later) corrected their information, but without acknowledging their error or taking the courtesy to respond.

Providing accurate information really is the easy stuff, but the rail industry seems intent on making its database of station information as inaccurate as the UK rail network is inaccessible.

Following the completion of the research into the 27 stations deferred by the Hendy Report, I also looked at the stations that were not deferred and I include a table of progress further down this blog.

The results make for grim reading, and some stations will be waiting for well over a decade following their original funding was agreed. It is continually the case that when cuts are made, the first cuts are made to accessibility projects. Further, Network Rail does not seem to have learned the lessons on effective project management discussed back in 2015.

Railway Stations deferred from CP5 2014-2019 to CP6 2019-2024

*Updated 9th September 2024

STATIONTRAIN OPERATING COMPANY Completion Date Comments
ALFRETONEast Midlands RailwayAt march 2023 – Due Spring/Summer 2024
*Feb 2024 Update – due for completion early 2025
TOC emailed for comment, no reply
BARNESSouth Western RailwayDue early 2024, delayed to by end of 2024Cost £5.7 million
BARRY (TOWN)Transport for WalesOpened July 2022
BATTERSEA PARKSouthernNo firm date for completionAs of Sep 23, cost estimate £20 million – £4m from AfA, the rest from developers’ contributions.
CATHAYSTransport for WalesLifts currently being built, estimated completion early 2025
CHATHAMSoutheasternOpened September 2022Cost £5.8 million
GARFORTHNorthernLifts due to open August 2024
*29th July Update from NR – lifts due to open in the Autumn 2024
Cost £6 million
GRAYSc2cWork due to start Jan 2024 and take 12 monthsNo ORR station categorisation.
HITHER GREENSoutheasternNo information on completion3.3m passengers annually.
LIVERPOOL CENTRALMerseyrailLifts opened
LLANELLITransport for WalesLifts currently being built
LUTONThameslinkAs of Sep 2023, work due to start Spring 2024.
*Update – work due to start August 2024
*Update October 2024 – work due to start ‘mid 2025’.
https://www.lutontoday.co.uk/news/transport/an-accessible-station-has-never-been-more-necessary-work-on-lifts-and-footbridge-at-luton-railway-station-delayed-until-spring-2025-4806679
MARKET HARBOROUGHEast Midlands RailwayLifts openedNational Rail Enquiries station map does not show lifts.
NORTHALLERTONTrans Pennine ExpressOpened March 2022
PECKHAM RYESouthernWork due to start 2026
PETTS WOODSoutheasternLifts opened early 2024Cost £10.79m
QUEEN’S PARKLondon UndergroundDelayed – No clear data available
SEVEN SISTERSLondon OvergroundNo data available
SOUTHEND EASTc2cNo data available
ST MARY CRAYSoutheasternLifts opened February 2022
STREATHAMSouthernLifts opened December 2023
THEALEGreat Western RailwayWork due to be completed either Winter 23/24 or Spring 2024 depending on source.Cost £9.5m
TREFFORESTTransport for WalesNo data availableCurrently classed as B2 station as per ORR classification.
WALTON-on-THAMESSouth Western RailwayLifts OpenClassed as B2 station due to steep gradient of ramp to platform 1.
WARWICKChilternWork currently paused
*Friday 6 September – work restarted estimated 6 months
Work paused due to finding foundations of original station.
WESTON-SUPER-MAREGreat Western RailwayPlans submitted in June 2023 *Plans re-submitted Nov 23 and July 24
WORCESTER SHRUB HILLWest Midlands RailwayWork due to be completed by the end of 2023. No lifts working at present.Currently classified as a B3 station

Misinformation

As I mentioned earlier, the time taken to research the above table was increased by the amount of conflicting information between the two main public facing databases for UK railway station information, the National Rail Access Map and the National Rail Enquiries station database – sometimes labelled somewhat disingenuously as ‘Stations made Easy’. There was conflicting information (stating there were lifts at the station when there are not) at the following stations: Cathays, Garforth, Grays, Hither Green, Llanelli, Peckham Rye, Queen’s Park, Seven Sisters, Southend East, Theale, Trefforest, Warwick, Weston-Super-Mare and Worcester Shrub Hill.

Following me highlighting these discrepancies in a lengthy twitter thread which you can find below, all of the station descriptions in the National Rail Map have now been corrected. Clearly some in the rail industry do read my social media, although I have to say most train operating companies did not give me the courtesy of acknowledging either my work, or their error. Many thanks to Southeastern, Transport for Wales and West Midlands Railway for getting in touch. Unfortunately, Great Western Railway, c2c, Southern, Northern, Chiltern and London Overground did not. I realise it is probably a personal failing of mine for getting a bit irked by this, but I wonder what a consultancy would charge the Train Operating Companies for the work I have done for nothing.

Twitter thread 16th July

https://x.com/julian_vaughan_/status/1813224223550181585

Just one example of the misinformation is Grays station, managed by c2c, where the station was described as having lifts although none are actually present. Further, the station does not have an accessibility categorisation as mandated by the Office of Rail and Road’s Accessible Travel Policy guidance. Well, it does, but the categorisation does not appear on either the National Rail Enquiries website, or the National Rail Map. Instead, it is buried under their FAQs section of their website, where it states it is a Category B station. Misleadingly, the description of accessibility at the station that they do provide, suggests that it is a Category A station. A link to my Twitter/X thread giving more detail on this here: https://x.com/julian_vaughan_/status/1820794330056966443

Grays station, Essex – managed by c2c

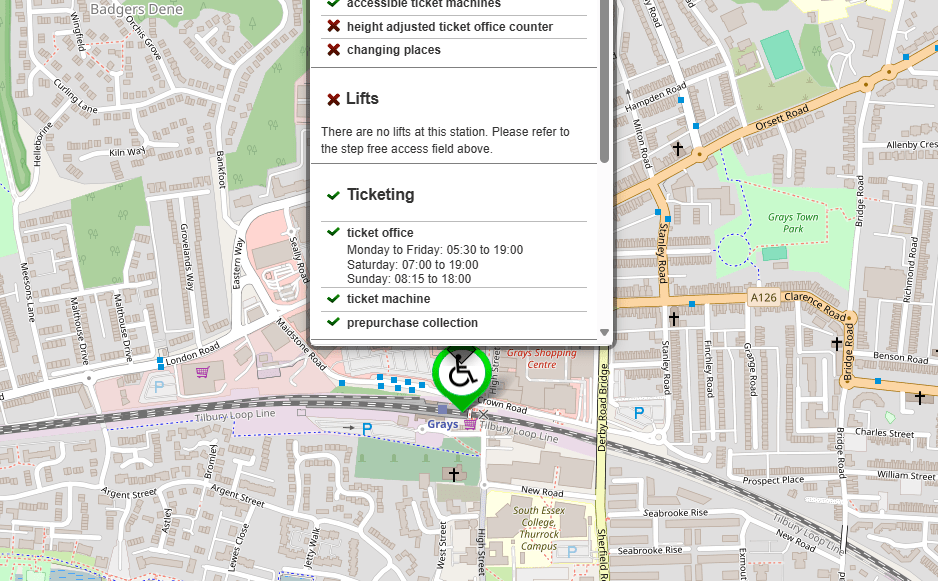

Original description of Grays railway station

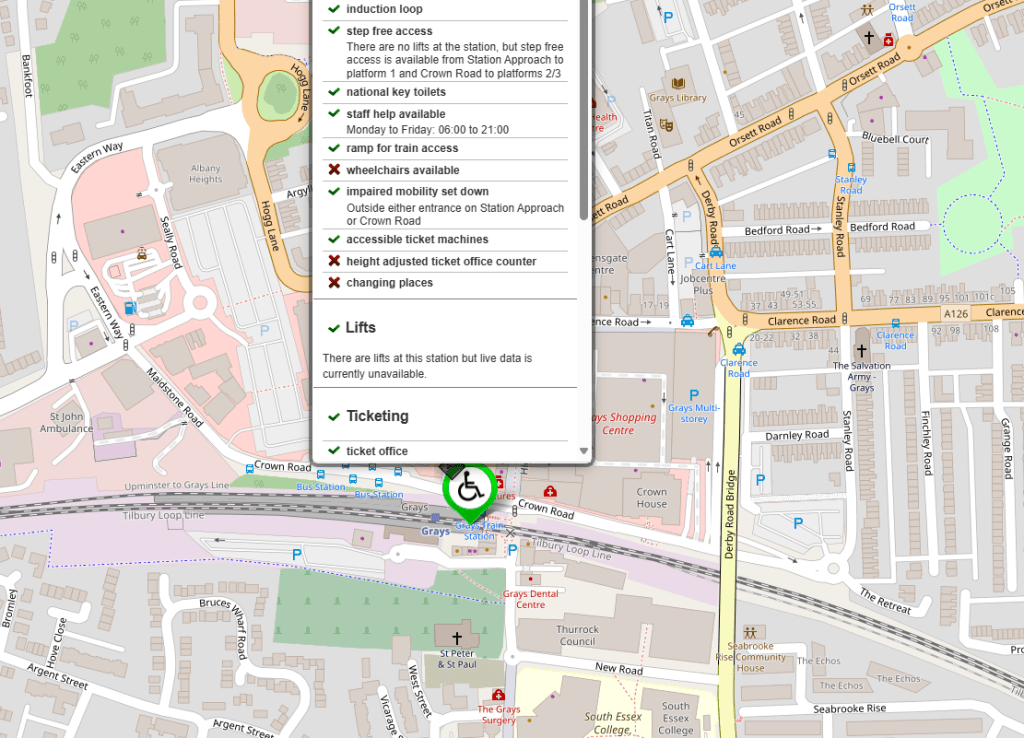

Amended description of Grays station

So, what happened to the stations that were not deferred and were due to have step-free routes by 2019, the end of Control Period 5? The data on these stations is set out below and it is a bit of a mixed bag.

Stations awarded Access for All funding for Control Period 5 (2014-2019)

StationCompletion Status and Comments
TeddingtonDue to start September 2023
CrawleyComplete
Palmers GreenDue for completion mid 2024
*October 2024 Update – work will now commence in 2025
https://enfielddispatch.co.uk/network-rail-sorry-for-delays-to-station-accessibility-upgrade/
Coulsdon SouthComplete
ShortlandsDue for completion Spring 2025
PlumsteadComplete March 2024 – National Rail Enquiries Map is out of date
SelhurstComplete
CarshaltonComplete August 2019
Canterbury EastComplete
BexleyLifts are open although National Rail Map says no lifts
Ewell WestComplete
Alexandra PalaceDue for completion Spring 2025
TringComplete in 2020 – cost £5.8m
StetchfordComplete but wrong information on National Rail Map
MeolsComplete 2020
Mills HillComplete 2020
TorquayStatus Unknown
TotnesComplete
ScunthorpeCompleted, although lifts only open during staffed hours – therefore should be classed as a B2 station rather than a Category A station
HeadingleyComplete in May 2019 although the national Rail Enquiries map still does not show the lifts at the station
Taffs WellLifts due to be completed imminently
TreherbertStatus Unknown

As it stands there remain a sizeable number of stations awarded funding for step-free access a decade ago, that today remain no-go areas for disabled people, people with restricted mobility and parents with young children. This is completely unacceptable.

Meanwhile, Network Rail continues to fail disabled people with poor project management, and judging by the number of project leads for my local step-free schemes in Bedfordshire, what seems to be a serious staff retention problem.

The lack of attention to detail around accessibility information is a symptom of the rail industry’s approach and of a culture where all the right things are said, but not followed up with actions. A tangible example of this culture is the decision of the Office of Rail and Road to remove any regulatory targets for Network Rail around ‘Accessibility’, instead leaving it to ‘assurance monitoring’. For clarity Network Rail has regulatory targets for almost every other aspect of their performance. I have included details of these targets in the ‘further reading’ section below. Rail industry bosses always talk about accessibility being a top priority. However, removing accessibility as a Key Performance Indicator and the lack of any target to indicate success or failure is a clear indication that it is not. There do not appear to be any consequences for failure. I hope the new Labour government will change this.

Reading Lord Hendy’s 2015 report and then listening to the top brass from Network Rail and the Department for Transport during their April 2024 appearance in front of the House of Commons Public Accounts Committee, I’m not clear that any lessons have been learned. They need to learn them fast; disabled people have waited long enough.

An accessible rail network intersects with numerous Labour values such as social justice, the drive to net zero, improving access to work, tackling congestion on our roads and reducing isolation and loneliness across our communities. Not only is a step-free rail network morally the right thing to do, but it also makes economic sense, and the proven economic return will only increase as our population ages.

It is clear we need a culture change within the rail industry, and this must be driven by making accessibility improvements a timebound legal requirement. We have legal targets for net zero carbon, we should have a legal target for making our rail network accessible too.

Julian Vaughan

8th August 2024

Sources and Further Reading

National Rail Access Map (launched by the Rail Delivery Group in 2019) https://accessmap.nationalrail.co.uk/

National Rail Enquiries – station information: https://www.nationalrail.co.uk/find-a-station/

Network Rail: Access for All Programme: https://www.networkrail.co.uk/communities/passengers/station-improvements/access-for-all-improving-accessibility-at-railway-stations-nationwide/

Office of Rail and Road: PR23 final determination – consolidated list of decisions: https://www.orr.gov.uk/sites/default/files/2023-11/05-pr23-final-determination-consolidated-list-of-decisions_1.pdf
